Sources
-
SHRM — How Many HR Staff Members Is Best? SHRM reported an average HR staff-to-employee ratio of 1.7 HR staff per 100 employees and notes that the right ratio varies by organization.
-
SHRM — Support for HR, Talent: CHRO Benchmarking Data Insights SHRM’s 2025 CHRO benchmarking reported a median HR-to-employee ratio of 1.98, nearly two HR employees per 100 employees.
-
Gallup — State of the Global Workplace 2026 Gallup reported global employee engagement fell to 20% in 2025, with major productivity-loss context.
-
Gallup — Why the Onboarding Experience Is Key for Retention Gallup reported that only 12% of employees strongly agree their organization does a great job onboarding.
-
Gallup — Q12 / Employee Engagement Resources Gallup connects employee engagement to business-unit productivity and related outcomes.
-
SHRM — Stack Ranking: The Hidden Cost of the Easy Way Out Replacement Cost Context.
-
SHRM — The Real Costs of Recruitment Replacement-cost context. SHRM has cited replacement costs between 50% and 200% of an employee’s salary depending on role and context.
-
Gallup — This Fixable Problem Costs U.S. Businesses $1 Trillion Replacement-cost context.
The work that would reduce future friction keeps getting delayed by today’s friction.
That is why HR projects often stay stuck.
Everyone agrees the project matters. Onboarding needs cleanup. Manager support tools need to be built. Hiring intake needs structure. Candidate communication needs consistency. Documentation needs to be updated. Workforce planning needs a rhythm. HR operations workflows need to be mapped. Escalation paths need clarity.
The project is not controversial.
It is just not getting done.
Daily HR work keeps taking priority because daily HR work is urgent, visible, and recurring. Employees need answers. Managers need support. Candidates need follow-up. New hires need onboarding. Hiring managers need feedback reminders. Leadership needs help with people-process questions. Something always needs attention now.
Meanwhile, the improvement work moves to next week. Then next month. Then next quarter.
That does not usually mean HR is procrastinating. It does not mean the HR team lacks strategic ability. It does not mean leadership is careless.
HR projects are often delayed because the work is important but structurally unprotected.
The fix is not just better prioritization. The fix is clearer ownership, protected capacity, scoped outcomes, and a practical support model.
Daily HR Work Versus HR Project Work
One of the easiest ways to understand delayed HR projects is to separate daily work from project work.
Daily HR work includes:
-
employee questions,
-
manager support,
-
hiring needs,
-
onboarding coordination,
-
urgent issues,
-
recurring workflows,
-
candidate communication,
-
process clarification,
-
and issue escalation.
This work cannot simply pause.
HR project work is different.
It includes:
-
onboarding redesign,
-
manager guides,
-
documentation cleanup,
-
hiring process improvement,
-
workforce planning rhythm,
-
candidate communication standards,
-
HR operations workflow mapping,
-
role clarity processes,
-
interview feedback improvements,
-
and escalation path design.
This work is often what reduces future friction.
But because it is less urgent in the moment, it is easier to postpone.
That is the tradeoff. Daily HR work keeps the business moving today. HR project work makes tomorrow easier.
When the business does not protect capacity for the second category, the first category keeps expanding.
Why HR Projects Keep Getting Delayed
Delayed HR projects usually have practical causes.
1. The project is important, but not urgent enough to win the day
Most HR projects are not ignored because they are unimportant.
They are delayed because something more immediate appears.
A manager needs help. A candidate is waiting. A new hire starts Monday. An employee question needs clarification. A leader needs input. A process gap creates a small fire.
The urgent work wins because it has a person attached to it.
The project loses because it represents future relief, not immediate pressure.
This is why HR improvement work needs structure. If it is treated as “when we have time” work, it will rarely have time.
2. The project is too broad
Many HR projects stall because they are defined too broadly.
-
“Fix onboarding.”
-
“Improve manager support.”
-
“Clean up hiring.”
-
“Document HR processes.”
-
“Build a workforce planning process.”
Those are real needs, but they are too large to move easily when the team is already stretched.
A broad project creates avoidance because no one knows where to start, how much time it will take, or what counts as done.
The project needs to become smaller and more concrete.
Instead of “fix onboarding,” the first deliverable might be:
-
define manager responsibilities for the first week,
-
create a pre-start checklist,
-
document the new-hire communication flow,
-
or build a 30-day onboarding template.
Smaller deliverables create movement.
3. No one owns the project clearly
An HR project can matter to everyone and belong to no one.
Leadership wants it. HR knows it is needed. Managers would benefit from it. Employees feel the gaps.
But who owns moving it?
Who defines the scope? Who approves decisions? Who gathers input? Who turns the idea into a workflow? Who decides when it is good enough to launch?
If ownership is unclear, the project becomes background noise.
Clear ownership does not mean one person does all the work. It means one person is responsible for moving the work through decisions, tradeoffs, and completion.
4. Daily coverage consumes the same people needed for improvement
The people who understand the HR project are often the same people consumed by daily HR work.
That creates a structural problem.
The HR leader who knows onboarding needs improvement is also answering manager questions. The recruiter who knows candidate communication needs cleanup is also moving open roles. The COO who sees the workflow gaps is also managing operational priorities. The people who can improve the system are too busy keeping the current system functioning.
This is the core capacity issue.
You cannot rely entirely on leftover time to build the systems that reduce future friction.
5. The project requires decisions, not just execution
Some HR projects look like execution work but actually require decisions.
For example:
-
Who owns onboarding?
-
What should managers be responsible for?
-
What hiring feedback standard should be required?
-
Which employee questions should go to HR?
-
What needs leadership approval?
-
What should be documented?
-
Which workflow should be standardized?
-
What level of consistency does the company actually want?
If those decisions are not made, the project stalls.
The work may appear to be delayed because no one has time to execute. But the deeper issue may be that no one has made the necessary choices.
6. The project exposes a broader operating gap
Some HR projects are delayed because they reveal bigger issues than expected.
An onboarding cleanup may expose unclear role ownership. A hiring process project may reveal manager misalignment. A documentation project may reveal that workflows are not actually defined. A workforce planning project may reveal that finance, operations, HR, and managers are not aligned on timing or priorities.
That does not mean the project is wrong.
It means the project is diagnosing something important.
When that happens, the company may need to rescope the work rather than abandon it.
7. There is no protected capacity
If the HR team is already at capacity, a project cannot survive on good intentions.
HR staffing benchmarks provide useful context. SHRM has reported an average HR staff-to-employee ratio of about 1.7 HR staff per 100 employees, while noting that the right ratio varies by organization. SHRM’s 2025 CHRO benchmarking reported a median HR-to-employee ratio of 1.98, nearly two HR employees per 100 employees. [Sources: SHRM HR staffing ratios; SHRM CHRO benchmarking]
Those numbers are not rules.
But they help explain why HR project work often stalls in lean teams.
A company may technically have HR coverage and still lack HR improvement capacity.
The Cost of Delayed HR Projects
Delayed HR projects do not stay neutral.
They create repeated friction.
Delayed onboarding improvement affects new hires and managers
When onboarding improvement keeps getting delayed, each new hire enters the same imperfect system.
Gallup has reported that only 12% of employees strongly agree their organization does a great job onboarding. [Source: Gallup onboarding]
For growing companies, this matters because onboarding is one of the first places where people systems become visible. Weak onboarding can create unclear expectations, inconsistent manager support, slower ramp time, and early confusion.
An onboarding project delayed for six months is not just a delayed HR task.
It affects every person hired during that period.
Delayed manager tools increase manager strain
Manager support projects are easy to postpone.
But managers keep needing support.
They need guidance on onboarding, hiring feedback, employee questions, escalation, communication, role clarity, and performance expectations.
Gallup’s 2026 workplace reporting shows global employee engagement at 20% in 2025 and identifies manager engagement as a major issue in the broader engagement picture. [Source: Gallup State of the Global Workplace]
If managers are already strained, delaying the tools that would help them creates more operating drag.
Delayed documentation creates repeated questions
Documentation projects may seem less urgent than daily HR work.
But undocumented workflows create repeated questions.
Employees ask where to find information. Managers ask how a process works. HR repeats explanations. Leadership gets pulled into preventable clarification. The same knowledge gets transmitted manually again and again.
Documentation is not valuable because documents are impressive.
It is valuable when it reduces repeat friction.
Delayed hiring process improvement slows growth
Hiring process projects often get delayed because open roles feel more urgent.
But if the hiring process itself is creating friction, every open role feels harder.
Weak intake, slow feedback, unclear decision ownership, inconsistent candidate communication, and unstructured interviews create repeat drag.
The company keeps pushing roles through a process that needs repair.
Delayed HR projects can affect retention risk
Delayed HR projects may contribute to conditions that increase turnover risk: weak onboarding, unclear expectations, inconsistent manager support, poor communication, unresolved friction, and repeated confusion.
Turnover is expensive. SHRM has cited employee replacement costs ranging from 50% to 200% of annual salary depending on role level and complexity. Gallup has similarly estimated that replacing an employee can cost one-half to two times the employee’s annual salary. [Sources: SHRM replacement cost; Gallup turnover cost]
Not every departure is preventable. But repeated people-process friction should not be ignored simply because it is not yet a crisis.
The HR Project Recovery Plan
If important HR projects keep getting delayed, use a recovery plan.
1. Name the project in business terms
Do not describe the project only as an HR task.
Translate it into business impact.
Instead of:
“Update onboarding.”
Say:
“Create a repeatable onboarding process so new hires receive consistent expectations, manager support, and first-week structure.”
Instead of:
“Improve hiring intake.”
Say:
“Reduce hiring rework by clarifying role outcomes, must-have criteria, manager ownership, and decision path before sourcing begins.”
Business language helps leaders understand why the project matters.
It also makes the project easier to prioritize.
2. Separate urgent coverage from improvement work
Identify what is daily coverage and what is improvement work.
Daily coverage may include employee questions, manager support, hiring coordination, candidate follow-up, and immediate issue response.
Improvement work may include documentation, manager guides, onboarding redesign, hiring workflow cleanup, and workforce planning rhythm.
Both matter.
But they need different capacity plans.
If daily coverage is consuming all available time, the improvement project needs protected capacity or outside support.
3. Define the smallest useful deliverable
Avoid trying to fix everything at once.
Define the smallest deliverable that would create meaningful progress.
Examples:
-
onboarding checklist for managers,
-
hiring intake template,
-
candidate communication standard,
-
employee question routing guide,
-
manager escalation path,
-
workforce planning input template,
-
interview feedback expectation,
-
HR operations workflow map.
The smallest useful deliverable should reduce real friction.
It should be narrow enough to complete and useful enough to matter.
4. Assign an internal owner
Every HR project needs an internal owner.
The owner does not need to do all the work. But they need to move the project through decisions.
The owner should:
-
define priorities,
-
gather input,
-
make or route decisions,
-
approve deliverables,
-
protect scope,
-
communicate progress,
-
and decide when the project is ready to launch.
Without ownership, projects drift.
5. Protect capacity or add support
If the project has been delayed multiple times, assume capacity is the issue until proven otherwise.
The company may need to:
-
protect internal project time,
-
reduce lower-priority work,
-
assign temporary support,
-
bring in contract HR support,
-
use fractional HR support,
-
scope project-based help,
-
or create a short diagnostic to clarify the project.
The key is to stop pretending the project will move through leftover time if leftover time has never appeared.
6. Set a decision and review rhythm
HR projects often stall when decisions are delayed.
Set a simple rhythm:
-
What decisions are needed this week?
-
Who makes them?
-
What is blocked?
-
What is ready for review?
-
What changed?
-
What is the next deliverable?
This does not need to become a heavy meeting.
It needs to keep the work moving.
7. Convert the project into an operating workflow
The project is not complete when the document is created.
It is complete when the workflow is usable.
For example:
-
An onboarding project should become the way managers onboard.
-
A hiring intake project should become the way roles are opened.
-
A candidate communication project should become the way updates happen.
-
A manager guide should become part of actual manager support.
-
A workforce planning template should become part of the planning rhythm.
The goal is not to finish an HR artifact.
The goal is to improve how work happens.
What Not to Assume
Do not assume HR is procrastinating.
Delayed projects often indicate capacity pressure.
Do not assume HR lacks strategic ability.
The team may know exactly what needs to improve.
Do not assume every delayed project needs outside help.
Some need clearer internal ownership or priority.
Do not assume daily HR work is less important.
It is essential.
Do not assume leaders are careless for postponing HR infrastructure.
They may be balancing real tradeoffs.
And do not assume the solution is always a larger HR team.
Sometimes the right answer is a small project, short-term support, protected capacity, or better scoping.
Where HIP Fits
Higher Impact People helps growing companies move delayed HR and talent projects forward by scoping the work, clarifying ownership, protecting internal judgment, and adding practical capacity around onboarding, hiring process, manager support, documentation, workforce planning, and HR operations workflows.
HIP is designed for companies where important people-process work keeps getting delayed because daily work consumes the available capacity.
That may include onboarding cleanup, hiring intake improvement, manager support tools, candidate communication workflows, employee question routing, HR documentation, escalation paths, role clarity processes, workforce planning setup, or HR operations mapping.
The goal is to help the company move useful work forward without overbuilding HR or replacing internal ownership.
Schedule an Alignment Call
If important HR or talent projects keep getting delayed because daily work consumes the available capacity, schedule an alignment call.
We will talk through what keeps slipping, what support may fit, and how to move the work forward responsibly.
~ Nicholas Brandenburg, PHR, SHRM-CP (Founder, Higher Impact People)

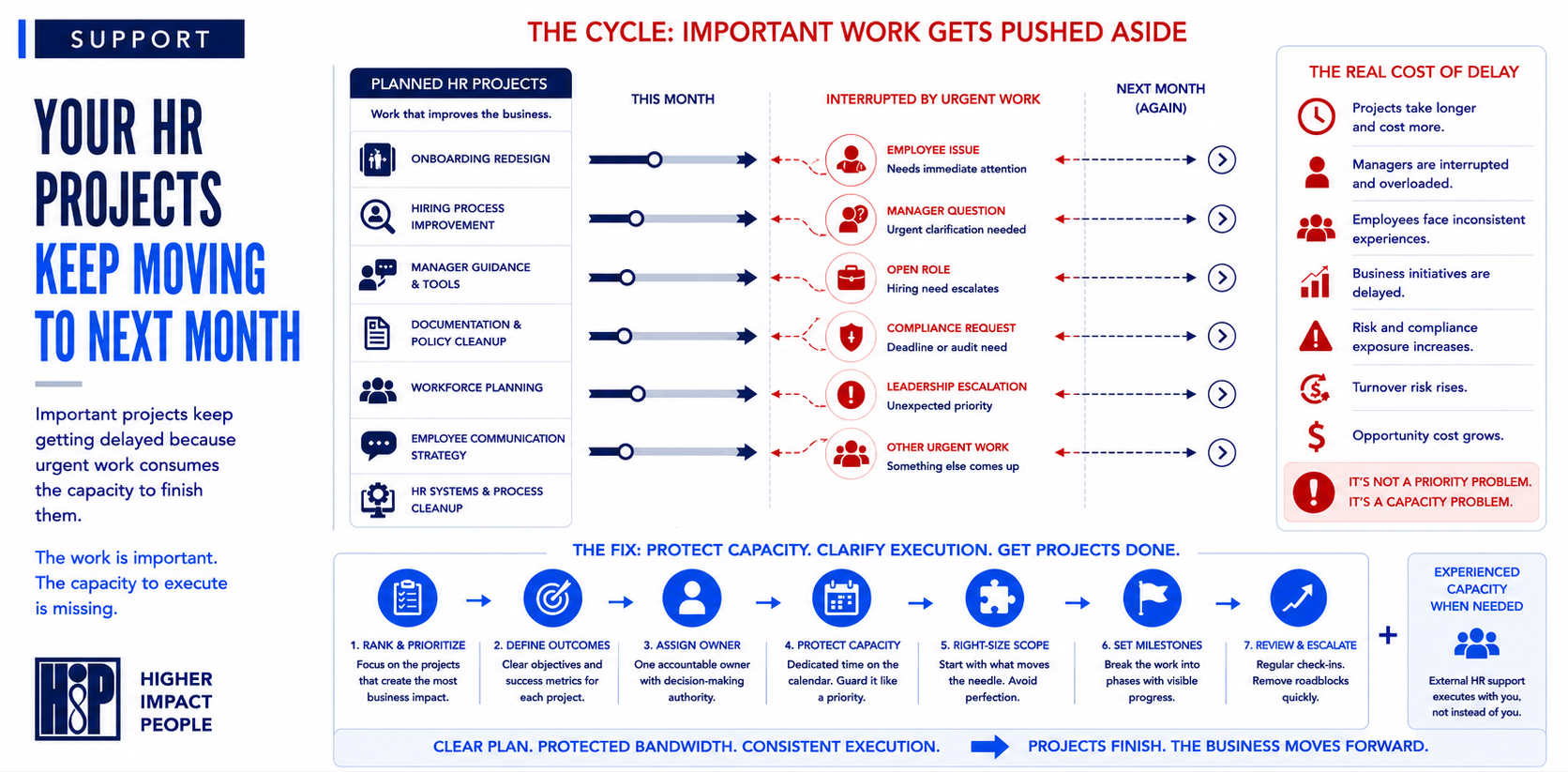

Why HR Projects Keep Getting Delayed
and What to Do About It

Sources
-
SHRM — How Many HR Staff Members Is Best? SHRM reported an average HR staff-to-employee ratio of 1.7 HR staff per 100 employees and notes that the right ratio varies by organization.
-
SHRM — Support for HR, Talent: CHRO Benchmarking Data Insights SHRM’s 2025 CHRO benchmarking reported a median HR-to-employee ratio of 1.98, nearly two HR employees per 100 employees.
-
Gallup — State of the Global Workplace 2026 Gallup reported global employee engagement fell to 20% in 2025, with major productivity-loss context.
-
Gallup — Why the Onboarding Experience Is Key for Retention Gallup reported that only 12% of employees strongly agree their organization does a great job onboarding.
-
Gallup — Q12 / Employee Engagement Resources Gallup connects employee engagement to business-unit productivity and related outcomes.
-
SHRM — Stack Ranking: The Hidden Cost of the Easy Way Out Replacement Cost Context.
-
SHRM — The Real Costs of Recruitment Replacement-cost context. SHRM has cited replacement costs between 50% and 200% of an employee’s salary depending on role and context.
-
Gallup — This Fixable Problem Costs U.S. Businesses $1 Trillion Replacement-cost context.
The work that would reduce future friction keeps getting delayed by today’s friction.
That is why HR projects often stay stuck.
Everyone agrees the project matters. Onboarding needs cleanup. Manager support tools need to be built. Hiring intake needs structure. Candidate communication needs consistency. Documentation needs to be updated. Workforce planning needs a rhythm. HR operations workflows need to be mapped. Escalation paths need clarity.
The project is not controversial.
It is just not getting done.
Daily HR work keeps taking priority because daily HR work is urgent, visible, and recurring. Employees need answers. Managers need support. Candidates need follow-up. New hires need onboarding. Hiring managers need feedback reminders. Leadership needs help with people-process questions. Something always needs attention now.
Meanwhile, the improvement work moves to next week. Then next month. Then next quarter.
That does not usually mean HR is procrastinating. It does not mean the HR team lacks strategic ability. It does not mean leadership is careless.
HR projects are often delayed because the work is important but structurally unprotected.
The fix is not just better prioritization. The fix is clearer ownership, protected capacity, scoped outcomes, and a practical support model.
Daily HR Work Versus HR Project Work
One of the easiest ways to understand delayed HR projects is to separate daily work from project work.
Daily HR work includes:
-
employee questions,
-
manager support,
-
hiring needs,
-
onboarding coordination,
-
urgent issues,
-
recurring workflows,
-
candidate communication,
-
process clarification,
-
and issue escalation.
This work cannot simply pause.
HR project work is different.
It includes:
-
onboarding redesign,
-
manager guides,
-
documentation cleanup,
-
hiring process improvement,
-
workforce planning rhythm,
-
candidate communication standards,
-
HR operations workflow mapping,
-
role clarity processes,
-
interview feedback improvements,
-
and escalation path design.
This work is often what reduces future friction.
But because it is less urgent in the moment, it is easier to postpone.
That is the tradeoff. Daily HR work keeps the business moving today. HR project work makes tomorrow easier.
When the business does not protect capacity for the second category, the first category keeps expanding.
Why HR Projects Keep Getting Delayed
Delayed HR projects usually have practical causes.
1. The project is important, but not urgent enough to win the day
Most HR projects are not ignored because they are unimportant.
They are delayed because something more immediate appears.
A manager needs help. A candidate is waiting. A new hire starts Monday. An employee question needs clarification. A leader needs input. A process gap creates a small fire.
The urgent work wins because it has a person attached to it.
The project loses because it represents future relief, not immediate pressure.
This is why HR improvement work needs structure. If it is treated as “when we have time” work, it will rarely have time.
2. The project is too broad
Many HR projects stall because they are defined too broadly.
-
“Fix onboarding.”
-
“Improve manager support.”
-
“Clean up hiring.”
-
“Document HR processes.”
-
“Build a workforce planning process.”
Those are real needs, but they are too large to move easily when the team is already stretched.
A broad project creates avoidance because no one knows where to start, how much time it will take, or what counts as done.
The project needs to become smaller and more concrete.
Instead of “fix onboarding,” the first deliverable might be:
-
define manager responsibilities for the first week,
-
create a pre-start checklist,
-
document the new-hire communication flow,
-
or build a 30-day onboarding template.
Smaller deliverables create movement.
3. No one owns the project clearly
An HR project can matter to everyone and belong to no one.
Leadership wants it. HR knows it is needed. Managers would benefit from it. Employees feel the gaps.
But who owns moving it?
Who defines the scope? Who approves decisions? Who gathers input? Who turns the idea into a workflow? Who decides when it is good enough to launch?
If ownership is unclear, the project becomes background noise.
Clear ownership does not mean one person does all the work. It means one person is responsible for moving the work through decisions, tradeoffs, and completion.
4. Daily coverage consumes the same people needed for improvement
The people who understand the HR project are often the same people consumed by daily HR work.
That creates a structural problem.
The HR leader who knows onboarding needs improvement is also answering manager questions. The recruiter who knows candidate communication needs cleanup is also moving open roles. The COO who sees the workflow gaps is also managing operational priorities. The people who can improve the system are too busy keeping the current system functioning.
This is the core capacity issue.
You cannot rely entirely on leftover time to build the systems that reduce future friction.
5. The project requires decisions, not just execution
Some HR projects look like execution work but actually require decisions.
For example:
-
Who owns onboarding?
-
What should managers be responsible for?
-
What hiring feedback standard should be required?
-
Which employee questions should go to HR?
-
What needs leadership approval?
-
What should be documented?
-
Which workflow should be standardized?
-
What level of consistency does the company actually want?
If those decisions are not made, the project stalls.
The work may appear to be delayed because no one has time to execute. But the deeper issue may be that no one has made the necessary choices.
6. The project exposes a broader operating gap
Some HR projects are delayed because they reveal bigger issues than expected.
An onboarding cleanup may expose unclear role ownership. A hiring process project may reveal manager misalignment. A documentation project may reveal that workflows are not actually defined. A workforce planning project may reveal that finance, operations, HR, and managers are not aligned on timing or priorities.
That does not mean the project is wrong.
It means the project is diagnosing something important.
When that happens, the company may need to rescope the work rather than abandon it.
7. There is no protected capacity
If the HR team is already at capacity, a project cannot survive on good intentions.
HR staffing benchmarks provide useful context. SHRM has reported an average HR staff-to-employee ratio of about 1.7 HR staff per 100 employees, while noting that the right ratio varies by organization. SHRM’s 2025 CHRO benchmarking reported a median HR-to-employee ratio of 1.98, nearly two HR employees per 100 employees. [Sources: SHRM HR staffing ratios; SHRM CHRO benchmarking]
Those numbers are not rules.
But they help explain why HR project work often stalls in lean teams.
A company may technically have HR coverage and still lack HR improvement capacity.
The Cost of Delayed HR Projects
Delayed HR projects do not stay neutral.
They create repeated friction.
Delayed onboarding improvement affects new hires and managers
When onboarding improvement keeps getting delayed, each new hire enters the same imperfect system.
Gallup has reported that only 12% of employees strongly agree their organization does a great job onboarding. [Source: Gallup onboarding]
For growing companies, this matters because onboarding is one of the first places where people systems become visible. Weak onboarding can create unclear expectations, inconsistent manager support, slower ramp time, and early confusion.
An onboarding project delayed for six months is not just a delayed HR task.
It affects every person hired during that period.
Delayed manager tools increase manager strain
Manager support projects are easy to postpone.
But managers keep needing support.
They need guidance on onboarding, hiring feedback, employee questions, escalation, communication, role clarity, and performance expectations.
Gallup’s 2026 workplace reporting shows global employee engagement at 20% in 2025 and identifies manager engagement as a major issue in the broader engagement picture. [Source: Gallup State of the Global Workplace]
If managers are already strained, delaying the tools that would help them creates more operating drag.
Delayed documentation creates repeated questions
Documentation projects may seem less urgent than daily HR work.
But undocumented workflows create repeated questions.
Employees ask where to find information. Managers ask how a process works. HR repeats explanations. Leadership gets pulled into preventable clarification. The same knowledge gets transmitted manually again and again.
Documentation is not valuable because documents are impressive.
It is valuable when it reduces repeat friction.
Delayed hiring process improvement slows growth
Hiring process projects often get delayed because open roles feel more urgent.
But if the hiring process itself is creating friction, every open role feels harder.
Weak intake, slow feedback, unclear decision ownership, inconsistent candidate communication, and unstructured interviews create repeat drag.
The company keeps pushing roles through a process that needs repair.
Delayed HR projects can affect retention risk
Delayed HR projects may contribute to conditions that increase turnover risk: weak onboarding, unclear expectations, inconsistent manager support, poor communication, unresolved friction, and repeated confusion.
Turnover is expensive. SHRM has cited employee replacement costs ranging from 50% to 200% of annual salary depending on role level and complexity. Gallup has similarly estimated that replacing an employee can cost one-half to two times the employee’s annual salary. [Sources: SHRM replacement cost; Gallup turnover cost]
Not every departure is preventable. But repeated people-process friction should not be ignored simply because it is not yet a crisis.
The HR Project Recovery Plan
If important HR projects keep getting delayed, use a recovery plan.
1. Name the project in business terms
Do not describe the project only as an HR task.
Translate it into business impact.
Instead of:
“Update onboarding.”
Say:
“Create a repeatable onboarding process so new hires receive consistent expectations, manager support, and first-week structure.”
Instead of:
“Improve hiring intake.”
Say:
“Reduce hiring rework by clarifying role outcomes, must-have criteria, manager ownership, and decision path before sourcing begins.”
Business language helps leaders understand why the project matters.
It also makes the project easier to prioritize.
2. Separate urgent coverage from improvement work
Identify what is daily coverage and what is improvement work.
Daily coverage may include employee questions, manager support, hiring coordination, candidate follow-up, and immediate issue response.
Improvement work may include documentation, manager guides, onboarding redesign, hiring workflow cleanup, and workforce planning rhythm.
Both matter.
But they need different capacity plans.
If daily coverage is consuming all available time, the improvement project needs protected capacity or outside support.
3. Define the smallest useful deliverable
Avoid trying to fix everything at once.
Define the smallest deliverable that would create meaningful progress.
Examples:
-
onboarding checklist for managers,
-
hiring intake template,
-
candidate communication standard,
-
employee question routing guide,
-
manager escalation path,
-
workforce planning input template,
-
interview feedback expectation,
-
HR operations workflow map.
The smallest useful deliverable should reduce real friction.
It should be narrow enough to complete and useful enough to matter.
4. Assign an internal owner
Every HR project needs an internal owner.
The owner does not need to do all the work. But they need to move the project through decisions.
The owner should:
-
define priorities,
-
gather input,
-
make or route decisions,
-
approve deliverables,
-
protect scope,
-
communicate progress,
-
and decide when the project is ready to launch.
Without ownership, projects drift.
5. Protect capacity or add support
If the project has been delayed multiple times, assume capacity is the issue until proven otherwise.
The company may need to:
-
protect internal project time,
-
reduce lower-priority work,
-
assign temporary support,
-
bring in contract HR support,
-
use fractional HR support,
-
scope project-based help,
-
or create a short diagnostic to clarify the project.
The key is to stop pretending the project will move through leftover time if leftover time has never appeared.
6. Set a decision and review rhythm
HR projects often stall when decisions are delayed.
Set a simple rhythm:
-
What decisions are needed this week?
-
Who makes them?
-
What is blocked?
-
What is ready for review?
-
What changed?
-
What is the next deliverable?
This does not need to become a heavy meeting.
It needs to keep the work moving.
7. Convert the project into an operating workflow
The project is not complete when the document is created.
It is complete when the workflow is usable.
For example:
-
An onboarding project should become the way managers onboard.
-
A hiring intake project should become the way roles are opened.
-
A candidate communication project should become the way updates happen.
-
A manager guide should become part of actual manager support.
-
A workforce planning template should become part of the planning rhythm.
The goal is not to finish an HR artifact.
The goal is to improve how work happens.
What Not to Assume
Do not assume HR is procrastinating.
Delayed projects often indicate capacity pressure.
Do not assume HR lacks strategic ability.
The team may know exactly what needs to improve.
Do not assume every delayed project needs outside help.
Some need clearer internal ownership or priority.
Do not assume daily HR work is less important.
It is essential.
Do not assume leaders are careless for postponing HR infrastructure.
They may be balancing real tradeoffs.
And do not assume the solution is always a larger HR team.
Sometimes the right answer is a small project, short-term support, protected capacity, or better scoping.
Where HIP Fits
Higher Impact People helps growing companies move delayed HR and talent projects forward by scoping the work, clarifying ownership, protecting internal judgment, and adding practical capacity around onboarding, hiring process, manager support, documentation, workforce planning, and HR operations workflows.
HIP is designed for companies where important people-process work keeps getting delayed because daily work consumes the available capacity.
That may include onboarding cleanup, hiring intake improvement, manager support tools, candidate communication workflows, employee question routing, HR documentation, escalation paths, role clarity processes, workforce planning setup, or HR operations mapping.
The goal is to help the company move useful work forward without overbuilding HR or replacing internal ownership.
Schedule an Alignment Call
If important HR or talent projects keep getting delayed because daily work consumes the available capacity, schedule an alignment call.
We will talk through what keeps slipping, what support may fit, and how to move the work forward responsibly.
~ Nicholas Brandenburg, PHR, SHRM-CP (Founder, Higher Impact People)
Why HR Projects Keep Getting Delayed
and What to Do About It

Sources
-
SHRM — How Many HR Staff Members Is Best? SHRM reported an average HR staff-to-employee ratio of 1.7 HR staff per 100 employees and notes that the right ratio varies by organization.
-
SHRM — Support for HR, Talent: CHRO Benchmarking Data Insights SHRM’s 2025 CHRO benchmarking reported a median HR-to-employee ratio of 1.98, nearly two HR employees per 100 employees.
-
Gallup — State of the Global Workplace 2026 Gallup reported global employee engagement fell to 20% in 2025, with major productivity-loss context.
-
Gallup — Why the Onboarding Experience Is Key for Retention Gallup reported that only 12% of employees strongly agree their organization does a great job onboarding.
-
Gallup — Q12 / Employee Engagement Resources Gallup connects employee engagement to business-unit productivity and related outcomes.
-
SHRM — Stack Ranking: The Hidden Cost of the Easy Way Out Replacement Cost Context.
-
SHRM — The Real Costs of Recruitment Replacement-cost context. SHRM has cited replacement costs between 50% and 200% of an employee’s salary depending on role and context.
-
Gallup — This Fixable Problem Costs U.S. Businesses $1 Trillion Replacement-cost context.
The work that would reduce future friction keeps getting delayed by today’s friction.
That is why HR projects often stay stuck.
Everyone agrees the project matters. Onboarding needs cleanup. Manager support tools need to be built. Hiring intake needs structure. Candidate communication needs consistency. Documentation needs to be updated. Workforce planning needs a rhythm. HR operations workflows need to be mapped. Escalation paths need clarity.
The project is not controversial.
It is just not getting done.
Daily HR work keeps taking priority because daily HR work is urgent, visible, and recurring. Employees need answers. Managers need support. Candidates need follow-up. New hires need onboarding. Hiring managers need feedback reminders. Leadership needs help with people-process questions. Something always needs attention now.
Meanwhile, the improvement work moves to next week. Then next month. Then next quarter.
That does not usually mean HR is procrastinating. It does not mean the HR team lacks strategic ability. It does not mean leadership is careless.
HR projects are often delayed because the work is important but structurally unprotected.
The fix is not just better prioritization. The fix is clearer ownership, protected capacity, scoped outcomes, and a practical support model.
Daily HR Work Versus HR Project Work
One of the easiest ways to understand delayed HR projects is to separate daily work from project work.
Daily HR work includes:
-
employee questions,
-
manager support,
-
hiring needs,
-
onboarding coordination,
-
urgent issues,
-
recurring workflows,
-
candidate communication,
-
process clarification,
-
and issue escalation.
This work cannot simply pause.
HR project work is different.
It includes:
-
onboarding redesign,
-
manager guides,
-
documentation cleanup,
-
hiring process improvement,
-
workforce planning rhythm,
-
candidate communication standards,
-
HR operations workflow mapping,
-
role clarity processes,
-
interview feedback improvements,
-
and escalation path design.
This work is often what reduces future friction.
But because it is less urgent in the moment, it is easier to postpone.
That is the tradeoff. Daily HR work keeps the business moving today. HR project work makes tomorrow easier.
When the business does not protect capacity for the second category, the first category keeps expanding.
Why HR Projects Keep Getting Delayed
Delayed HR projects usually have practical causes.
1. The project is important, but not urgent enough to win the day
Most HR projects are not ignored because they are unimportant.
They are delayed because something more immediate appears.
A manager needs help. A candidate is waiting. A new hire starts Monday. An employee question needs clarification. A leader needs input. A process gap creates a small fire.
The urgent work wins because it has a person attached to it.
The project loses because it represents future relief, not immediate pressure.
This is why HR improvement work needs structure. If it is treated as “when we have time” work, it will rarely have time.
2. The project is too broad
Many HR projects stall because they are defined too broadly.
-
“Fix onboarding.”
-
“Improve manager support.”
-
“Clean up hiring.”
-
“Document HR processes.”
-
“Build a workforce planning process.”
Those are real needs, but they are too large to move easily when the team is already stretched.
A broad project creates avoidance because no one knows where to start, how much time it will take, or what counts as done.
The project needs to become smaller and more concrete.
Instead of “fix onboarding,” the first deliverable might be:
-
define manager responsibilities for the first week,
-
create a pre-start checklist,
-
document the new-hire communication flow,
-
or build a 30-day onboarding template.
Smaller deliverables create movement.
3. No one owns the project clearly
An HR project can matter to everyone and belong to no one.
Leadership wants it. HR knows it is needed. Managers would benefit from it. Employees feel the gaps.
But who owns moving it?
Who defines the scope? Who approves decisions? Who gathers input? Who turns the idea into a workflow? Who decides when it is good enough to launch?
If ownership is unclear, the project becomes background noise.
Clear ownership does not mean one person does all the work. It means one person is responsible for moving the work through decisions, tradeoffs, and completion.
4. Daily coverage consumes the same people needed for improvement
The people who understand the HR project are often the same people consumed by daily HR work.
That creates a structural problem.
The HR leader who knows onboarding needs improvement is also answering manager questions. The recruiter who knows candidate communication needs cleanup is also moving open roles. The COO who sees the workflow gaps is also managing operational priorities. The people who can improve the system are too busy keeping the current system functioning.
This is the core capacity issue.
You cannot rely entirely on leftover time to build the systems that reduce future friction.
5. The project requires decisions, not just execution
Some HR projects look like execution work but actually require decisions.
For example:
-
Who owns onboarding?
-
What should managers be responsible for?
-
What hiring feedback standard should be required?
-
Which employee questions should go to HR?
-
What needs leadership approval?
-
What should be documented?
-
Which workflow should be standardized?
-
What level of consistency does the company actually want?
If those decisions are not made, the project stalls.
The work may appear to be delayed because no one has time to execute. But the deeper issue may be that no one has made the necessary choices.
6. The project exposes a broader operating gap
Some HR projects are delayed because they reveal bigger issues than expected.
An onboarding cleanup may expose unclear role ownership. A hiring process project may reveal manager misalignment. A documentation project may reveal that workflows are not actually defined. A workforce planning project may reveal that finance, operations, HR, and managers are not aligned on timing or priorities.
That does not mean the project is wrong.
It means the project is diagnosing something important.
When that happens, the company may need to rescope the work rather than abandon it.
7. There is no protected capacity
If the HR team is already at capacity, a project cannot survive on good intentions.
HR staffing benchmarks provide useful context. SHRM has reported an average HR staff-to-employee ratio of about 1.7 HR staff per 100 employees, while noting that the right ratio varies by organization. SHRM’s 2025 CHRO benchmarking reported a median HR-to-employee ratio of 1.98, nearly two HR employees per 100 employees. [Sources: SHRM HR staffing ratios; SHRM CHRO benchmarking]
Those numbers are not rules.
But they help explain why HR project work often stalls in lean teams.
A company may technically have HR coverage and still lack HR improvement capacity.
The Cost of Delayed HR Projects
Delayed HR projects do not stay neutral.
They create repeated friction.
Delayed onboarding improvement affects new hires and managers
When onboarding improvement keeps getting delayed, each new hire enters the same imperfect system.
Gallup has reported that only 12% of employees strongly agree their organization does a great job onboarding. [Source: Gallup onboarding]
For growing companies, this matters because onboarding is one of the first places where people systems become visible. Weak onboarding can create unclear expectations, inconsistent manager support, slower ramp time, and early confusion.
An onboarding project delayed for six months is not just a delayed HR task.
It affects every person hired during that period.
Delayed manager tools increase manager strain
Manager support projects are easy to postpone.
But managers keep needing support.
They need guidance on onboarding, hiring feedback, employee questions, escalation, communication, role clarity, and performance expectations.
Gallup’s 2026 workplace reporting shows global employee engagement at 20% in 2025 and identifies manager engagement as a major issue in the broader engagement picture. [Source: Gallup State of the Global Workplace]
If managers are already strained, delaying the tools that would help them creates more operating drag.
Delayed documentation creates repeated questions
Documentation projects may seem less urgent than daily HR work.
But undocumented workflows create repeated questions.
Employees ask where to find information. Managers ask how a process works. HR repeats explanations. Leadership gets pulled into preventable clarification. The same knowledge gets transmitted manually again and again.
Documentation is not valuable because documents are impressive.
It is valuable when it reduces repeat friction.
Delayed hiring process improvement slows growth
Hiring process projects often get delayed because open roles feel more urgent.
But if the hiring process itself is creating friction, every open role feels harder.
Weak intake, slow feedback, unclear decision ownership, inconsistent candidate communication, and unstructured interviews create repeat drag.
The company keeps pushing roles through a process that needs repair.
Delayed HR projects can affect retention risk
Delayed HR projects may contribute to conditions that increase turnover risk: weak onboarding, unclear expectations, inconsistent manager support, poor communication, unresolved friction, and repeated confusion.
Turnover is expensive. SHRM has cited employee replacement costs ranging from 50% to 200% of annual salary depending on role level and complexity. Gallup has similarly estimated that replacing an employee can cost one-half to two times the employee’s annual salary. [Sources: SHRM replacement cost; Gallup turnover cost]
Not every departure is preventable. But repeated people-process friction should not be ignored simply because it is not yet a crisis.
The HR Project Recovery Plan
If important HR projects keep getting delayed, use a recovery plan.
1. Name the project in business terms
Do not describe the project only as an HR task.
Translate it into business impact.
Instead of:
“Update onboarding.”
Say:
“Create a repeatable onboarding process so new hires receive consistent expectations, manager support, and first-week structure.”
Instead of:
“Improve hiring intake.”
Say:
“Reduce hiring rework by clarifying role outcomes, must-have criteria, manager ownership, and decision path before sourcing begins.”
Business language helps leaders understand why the project matters.
It also makes the project easier to prioritize.
2. Separate urgent coverage from improvement work
Identify what is daily coverage and what is improvement work.
Daily coverage may include employee questions, manager support, hiring coordination, candidate follow-up, and immediate issue response.
Improvement work may include documentation, manager guides, onboarding redesign, hiring workflow cleanup, and workforce planning rhythm.
Both matter.
But they need different capacity plans.
If daily coverage is consuming all available time, the improvement project needs protected capacity or outside support.
3. Define the smallest useful deliverable
Avoid trying to fix everything at once.
Define the smallest deliverable that would create meaningful progress.
Examples:
-
onboarding checklist for managers,
-
hiring intake template,
-
candidate communication standard,
-
employee question routing guide,
-
manager escalation path,
-
workforce planning input template,
-
interview feedback expectation,
-
HR operations workflow map.
The smallest useful deliverable should reduce real friction.
It should be narrow enough to complete and useful enough to matter.
4. Assign an internal owner
Every HR project needs an internal owner.
The owner does not need to do all the work. But they need to move the project through decisions.
The owner should:
-
define priorities,
-
gather input,
-
make or route decisions,
-
approve deliverables,
-
protect scope,
-
communicate progress,
-
and decide when the project is ready to launch.
Without ownership, projects drift.
5. Protect capacity or add support
If the project has been delayed multiple times, assume capacity is the issue until proven otherwise.
The company may need to:
-
protect internal project time,
-
reduce lower-priority work,
-
assign temporary support,
-
bring in contract HR support,
-
use fractional HR support,
-
scope project-based help,
-
or create a short diagnostic to clarify the project.
The key is to stop pretending the project will move through leftover time if leftover time has never appeared.
6. Set a decision and review rhythm
HR projects often stall when decisions are delayed.
Set a simple rhythm:
-
What decisions are needed this week?
-
Who makes them?
-
What is blocked?
-
What is ready for review?
-
What changed?
-
What is the next deliverable?
This does not need to become a heavy meeting.
It needs to keep the work moving.
7. Convert the project into an operating workflow
The project is not complete when the document is created.
It is complete when the workflow is usable.
For example:
-
An onboarding project should become the way managers onboard.
-
A hiring intake project should become the way roles are opened.
-
A candidate communication project should become the way updates happen.
-
A manager guide should become part of actual manager support.
-
A workforce planning template should become part of the planning rhythm.
The goal is not to finish an HR artifact.
The goal is to improve how work happens.
What Not to Assume
Do not assume HR is procrastinating.
Delayed projects often indicate capacity pressure.
Do not assume HR lacks strategic ability.
The team may know exactly what needs to improve.
Do not assume every delayed project needs outside help.
Some need clearer internal ownership or priority.
Do not assume daily HR work is less important.
It is essential.
Do not assume leaders are careless for postponing HR infrastructure.
They may be balancing real tradeoffs.
And do not assume the solution is always a larger HR team.
Sometimes the right answer is a small project, short-term support, protected capacity, or better scoping.
Where HIP Fits
Higher Impact People helps growing companies move delayed HR and talent projects forward by scoping the work, clarifying ownership, protecting internal judgment, and adding practical capacity around onboarding, hiring process, manager support, documentation, workforce planning, and HR operations workflows.
HIP is designed for companies where important people-process work keeps getting delayed because daily work consumes the available capacity.
That may include onboarding cleanup, hiring intake improvement, manager support tools, candidate communication workflows, employee question routing, HR documentation, escalation paths, role clarity processes, workforce planning setup, or HR operations mapping.
The goal is to help the company move useful work forward without overbuilding HR or replacing internal ownership.
Schedule an Alignment Call
If important HR or talent projects keep getting delayed because daily work consumes the available capacity, schedule an alignment call.
We will talk through what keeps slipping, what support may fit, and how to move the work forward responsibly.
~ Nicholas Brandenburg, PHR, SHRM-CP (Founder, Higher Impact People)
Why HR Projects Keep Getting Delayed and
What to Do About It

350 Lincoln Street, Suite 2400
Hingham, MA 02043
© 2026 Higher Impact People, LLC
All rights reserved.
350 Lincoln Street, Suite 2400
Hingham, MA 02043
© 2026 Higher Impact People, LLC
